In August of 1619, the arrival of the first African Americans began 246 years of slavery in the United States of America. This historical event occurred at Old Point Comfort in Fort Monroe, Virginia. In 1865, the United States abolished slavery. Sadly, generations still faced many decades of violence, intimidation and discrimination. Today, Fort Monroe honors enslaved Africans and their descendants. Through historical sites, commemorative events, and exhibits, the significant impact they had on American history and culture is celebrated and shared.
The project involves the African Landing Memorial constructed within a plaza consisting of a three-piece sculpture and a line to Angola. The site design includes a plaza to feature the artistic works chosen by Fort Monroe Authority, a structure for the art to be displays and a site development to ensure connectivity and accessibility. Our project is primarily characterized as an outdoor monument located along the Chesapeake Bay, at the southern edge of the Fort Monroe National Monument. It encompasses various elements, including site preparation, concrete flatwork and footings, underground utilities, paving and striping, as well as landscaping.
December 2024
Today marks the first day of breaking ground! We conducted a munitions orientation and provided an overview of phase one, which includes the installation of our erosion control measures, specifically super silt fencing in a couple zones. Additionally, we began the demolition of the sidewalk.
January 2025

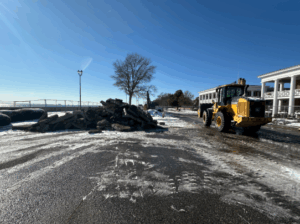

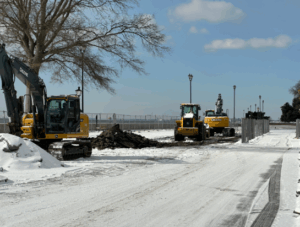

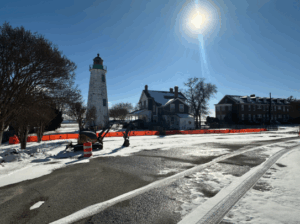

With snow covering the ground, the teams are ready to spring into action!

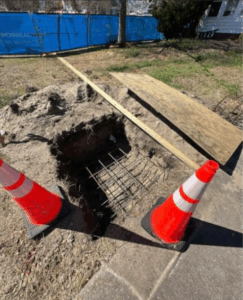

An assessment of the concrete in the active sections is completed. There are always concerns regarding a nearby potential historic scale; however, we are diligent in confirming that the concrete subgrade is not historic and can be removed. We remain vigilant for any scales that may be located beneath the concrete. Athens is dedicated to ensuring that all aspects of history are preserved and cared for.
This included both asphalt and concrete removal.
April 2025

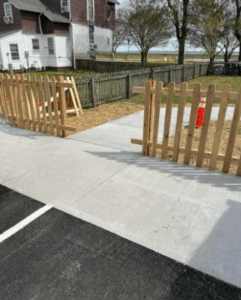

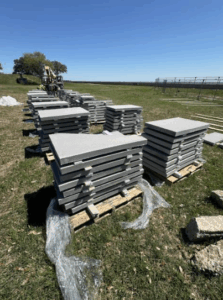

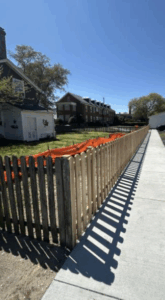

Cedar fence installation is finished. The wood guardrail has also been completed! Pavers have been delivered and unloaded, and the team has started the process of laying them out!

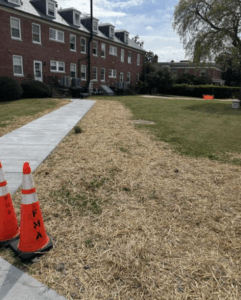

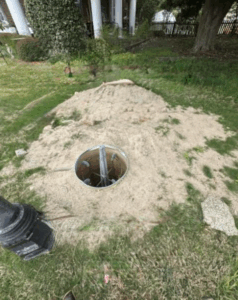

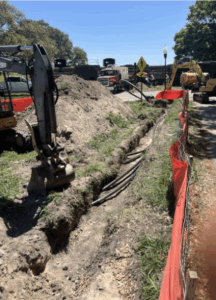

One crew worked on water line backflow, hose bibs, and backfill in Area A, and completed seed and straw at new sidewalks and parking in Area E. Multiple LPBs have been poured and are at various stages of restoration—some still require forming, pouring, or grading. Remaining LPB and Fenwick locations need conduit, bracing, and restoration. Fence gates still need to be built and sealed after the cedar dries.

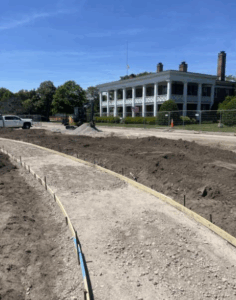

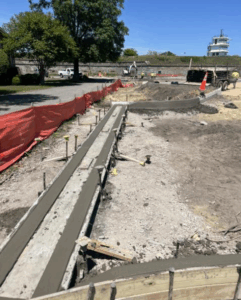

Plaza Art Wall Foundation Mats and Forms & Sidewalk in Area A Updates

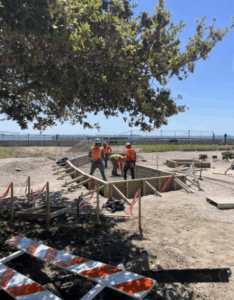

The foundation mats and forms for the art wall are being meticulously crafted, ensuring they serve as a sturdy base for the upcoming installation.

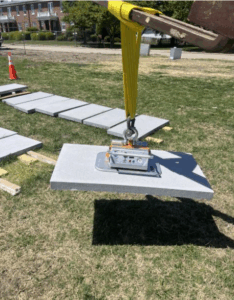

The above photo shows the Paver Vacuum Lift. The equipment simplifies placing heavy pavers with precision and efficiency. This tool reduces injury risk and ensures perfect alignment. Its advanced technology speeds up projects while maintaining quality. Our crew values the enhanced safety and productivity it offers, making it a valuable addition. We are committed to delivering superior results.

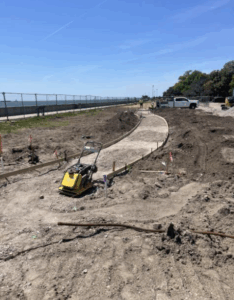

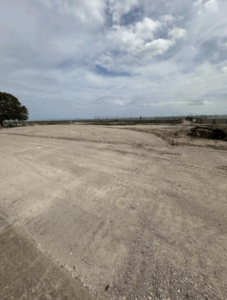

Proof Roll Preparation of Constuction site along with Boring, Radius Curbing, Trench Drain
